Manufacturing Analytics Software: What Program-Delivery and Machine Data Reveal About Shop-Floor Performance A scrap event lands on a Tuesday afternoon. The part is out of tolerance, the machine looks fine, and the operator swears nothing changed. Three days later, someone finds it: the machine had been running a superseded CNC program because a file transfer failed silently the week before.

This is the visibility gap that plagues most CNC machine shops. A production delay or quality deviation gets blamed on the machine when the real cause sits upstream, in an outdated program, a failed transfer, or a mismatch between what engineering approved and what the machine actually ran.

Manufacturing analytics software closes that gap by combining program-delivery data with machine and production data. Together, they show not just what happened on the shop floor, but where execution diverged from engineering intent.

This article covers where analytics data comes from, what program-delivery and machine records reveal, how that data drives better decisions, and how US manufacturers should evaluate and roll out these systems.

Key Takeaways

  • Program-delivery data ties each job to a file, revision, and transfer; machine data shows how equipment actually ran
  • Combining both streams tightens traceability for scrap, rework, quality escapes, and downtime
  • Trustworthy analytics require synced timestamps, consistent machine/job IDs, and governed program revisions
  • Start with one bottleneck or quality problem before expanding analytics facility-wide

What Is Manufacturing Analytics Software and Where Does Its Data Come From?

Manufacturing analytics software collects, contextualizes, analyzes, and visualizes data pulled from production equipment, CNC/DNC systems, engineering workflows, operators, and business applications. It turns scattered signals into evidence you can act on.

Monitoring Versus Analytics

Monitoring and analytics aren't the same thing, even though the terms get used interchangeably. Monitoring tells you the current state of a machine right now. Analytics goes further; it identifies patterns, compares performance across shifts or programs, investigates root causes, and supports corrective action.

A useful frame here is Gartner's breakdown of data and analytics maturity, which describes four progressively deeper questions:

  • Descriptive: What happened to output, downtime, cycle time, quality, or program usage?
  • Diagnostic: Why did a machine, job, shift, or program revision perform differently?
  • Predictive: What conditions suggest an upcoming failure, delay, or capacity constraint?
  • Prescriptive: What maintenance, scheduling, or process action should happen next?

Where the Data Actually Comes From

Four data sources feed real manufacturing analytics:

  • Program-delivery data — approved file name, revision, transfer time, destination machine, operator, transfer status, and change history
  • Machine data — run, idle, alarm, feed, spindle, cycle, tool, temperature, vibration, and controller status signals
  • Production and quality data — work orders, part numbers, inspection outcomes, scrap, rework, and completion times
  • Business-system data — ERP, MES, CMMS, scheduling, inventory, and delivery records

None of these sources tells the full story alone. The strongest insights come from correlating them using shared identifiers, like job number or machine ID, and matching timestamps. A machine log without program context is just noise with a timestamp.

What Do Program-Delivery and Machine Data Reveal About Shop-Floor Performance?

This is where the two data streams start earning their keep.

Digital Traceability From Engineering to the Machine

Program-delivery records establish a chain of custody for CNC files. That chain answers questions investigators actually need answered:

  • Did the machine receive the latest approved program, or an older revision?
  • Did the file transfer complete, or did the operator pull a local, unauthorized copy instead?
  • What revision history exists for this part number, and does it line up with when quality problems started?

Systems like Machine Link™ QUICK Serve continuously scan machines for file requests and serve the current engineering-approved program directly to the control. Any edits made at the machine route back to engineering for review before they become part of the standard library, rather than living as an unofficial local variant.

That said, revision history alone doesn't prove causation. Analytics should help investigators compare program versions against quality and machine outcomes, not assert that a program caused a defect without supporting evidence.

Machine-State Data and Throughput

Machine data reveals utilization by breaking total time into distinct categories:

Category What It Captures
Scheduled/Available Time Time the machine was planned to run
Run Time Actual production time
Idle Time Machine available but not cutting
Setup Time Changeovers and program loading
Alarm Time Faults and unplanned stops
Maintenance Time Planned or unplanned service

Cycle-time variation becomes meaningful when tied to part number, program revision, machine, tool condition, operator, and shift. A cycle time that drifts 8% on one machine but not others, running the same program, points to a specific investigation, not a general complaint about "the machines running slow."

Connecting Machine Events to Delivery and Quality

Analytics lets you trace a late job backward: missed schedule, then a program-transfer delay, then downtime, then queue changes, then the final delivery impact. That sequence either confirms a one-time incident or exposes a repeatable pattern worth fixing structurally.

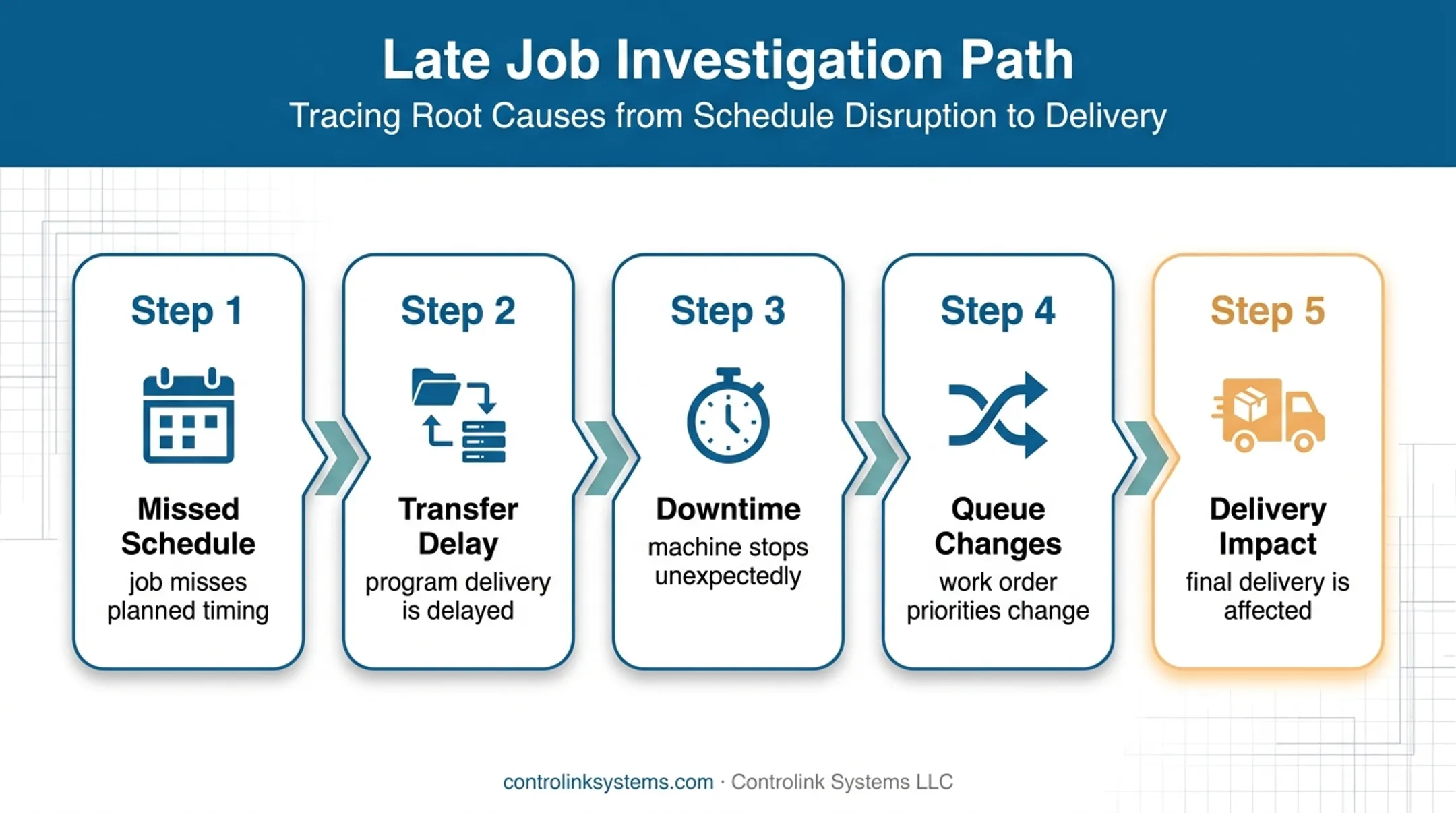

Five-stage manufacturing analytics traceability path from delay to delivery impact

The same logic applies to quality. Comparing first-pass yield, scrap, and rework against the program and machine conditions present during that production run narrows the search dramatically.

Alerts Worth Acting On

Not every anomaly deserves a ping. Signals worth flagging include:

  • Repeated failed program transfers
  • A machine running an unexpected revision
  • Rising alarm frequency
  • Unusual cycle-time drift
  • Repeated quality deviations tied to the same job or machine

Alerts need thresholds, an owner, an escalation path, and a verification step. Without those, alerts turn into noise operators learn to ignore within a week.

A practical example: Engineering approves a new revision and pushes it to five CNC machines. Four update successfully. One keeps running the older file because of a connectivity hiccup during transfer.

Two shifts later, that machine's scrap rate climbs. Analytics flags the revision mismatch, correlates it with the quality shift, and creates a documented corrective-action trail, rather than leaving the connection to guesswork.

Where the Data Can Mislead You

Common sources of false confidence include:

  • Incomplete sensor coverage
  • Inconsistent machine naming
  • Missing operator context
  • Unsynchronized clocks
  • Manual status overrides
  • Ungoverned local program files

Record data lineage and confidence levels whenever you present analytics to production, quality, engineering, or maintenance teams. A dashboard that hides its own gaps is more dangerous than no dashboard at all.

How Can Manufacturing Analytics Improve Shop-Floor Decisions?

Analytics only matters if it changes a decision. Here's how that plays out by function.

Quality and Traceability

When a defect or recall investigation happens, teams need answers fast. Controlled program delivery also cuts the chance machinists run superseded engineering-approved files.

Traceability pulls together:

  • Machine and job
  • Program revision
  • Material batch
  • Time window

When a defect or recall investigation happens, teams need answers fast. Controlled program delivery also cuts the chance machinists run superseded engineering-approved files.

Traceability pulls together:

  • Machine and job
  • Program revision
  • Material batch
  • Time window

That speed shortens containment and keeps wrong-revision runs from becoming scrap or escapes.

Downtime and Maintenance

Analytics separates planned maintenance from unplanned stoppages and flags recurring conditions behind both. Where equipment and connectivity allow, condition signals can feed predictive programs:

  • Vibration and temperature
  • Spindle load
  • Cycle behavior

The gap between reactive and predictive work is large. A 2021 NIST survey of manufacturing machinery maintenance found facilities that leaned on predictive and preventive maintenance reported 52.7% less unplanned downtime and 78.5% fewer defects than reactive peers.

Predictive maintenance versus reactive maintenance downtime and defect comparison

That is a cross-group survey comparison, not a promise for every shop—but the direction is clear.

Productivity and Capacity

Live shop data beats planned standards alone for capacity calls:

  • Actual cycle time
  • Setup and queue duration
  • Machine availability

Supervisors can prioritize work, move jobs between machines, or chase a bottleneck with current evidence instead of a routing sheet written months ago.

Engineering and Continuous Improvement

Comparing program revisions against machine outcomes helps engineering evaluate process changes, standardize what's actually working, and catch where approved instructions aren't being followed on the floor. Drill-down dashboards support root-cause analysis by machine, job, part, shift, or program, so engineers aren't reconstructing timelines from memory.

People and Operating Discipline

Analytics works best as a decision-support tool, not a surveillance system. A few adoption practices matter here:

  • Involve machinists in defining downtime and status categories
  • Validate downtime reasons with the people entering them
  • Display relevant information near the point of work, not buried in a report nobody opens

When operators see analytics fix real floor problems, the data they enter stays accurate.

How Should a Manufacturer Implement and Evaluate Analytics Software?

Start narrow. Pick one measurable problem: repeated scrap on a bottleneck machine, unreliable cycle-time standards, failed CNC program transfers, or poor downtime visibility. Trying to instrument the entire plant on day one is how these projects stall.

Build a Data-Readiness Checklist

Before evaluating software, take stock of what you have:

  • Inventory CNC controllers, DNC/file-transfer systems, PLCs, sensors, and existing ERP/MES/CMMS applications
  • Standardize identifiers for machines, parts, work orders, programs, revisions, and operators
  • Synchronize timestamps and document how run, idle, alarm, and setup states get determined
  • Assign ownership for program approval, change control, and corrective action

Evaluate Software Against These Questions

  • Can it connect to your CNC/DNC, PLC, sensor, and ERP/MES environments?
  • Does it capture program-delivery status, revision history, and machine execution context together?
  • Does it support your protocols (Modbus, Profinet, EtherCAT) and expose APIs for later integration?
  • Can a user move from a high-level KPI down to the specific machine, job, program, or quality event behind it?
  • Are permissions, audit trails, and data retention policies clearly documented?
  • Can operators and supervisors use it with minimal training on the shop floor?

Pilot Before You Scale

Select a bottleneck process, establish a baseline, and verify data accuracy directly with operators and engineers before trusting the output for formal decisions. Compare analytics results against your approved production and quality records first.

Staged rollouts tend to outperform big-bang deployments. A 2024 NIST Manufacturing Extension Partnership case study describes a manufacturer that connected legacy stamping presses and robotic welding cells to an MES with sensors and real-time tracking. First units shipped three months after kickoff, ahead of schedule, and OEE improved by nearly 40 percentage points within a year. That's one documented case, not a universal benchmark, but it illustrates what a focused, phased approach can achieve.

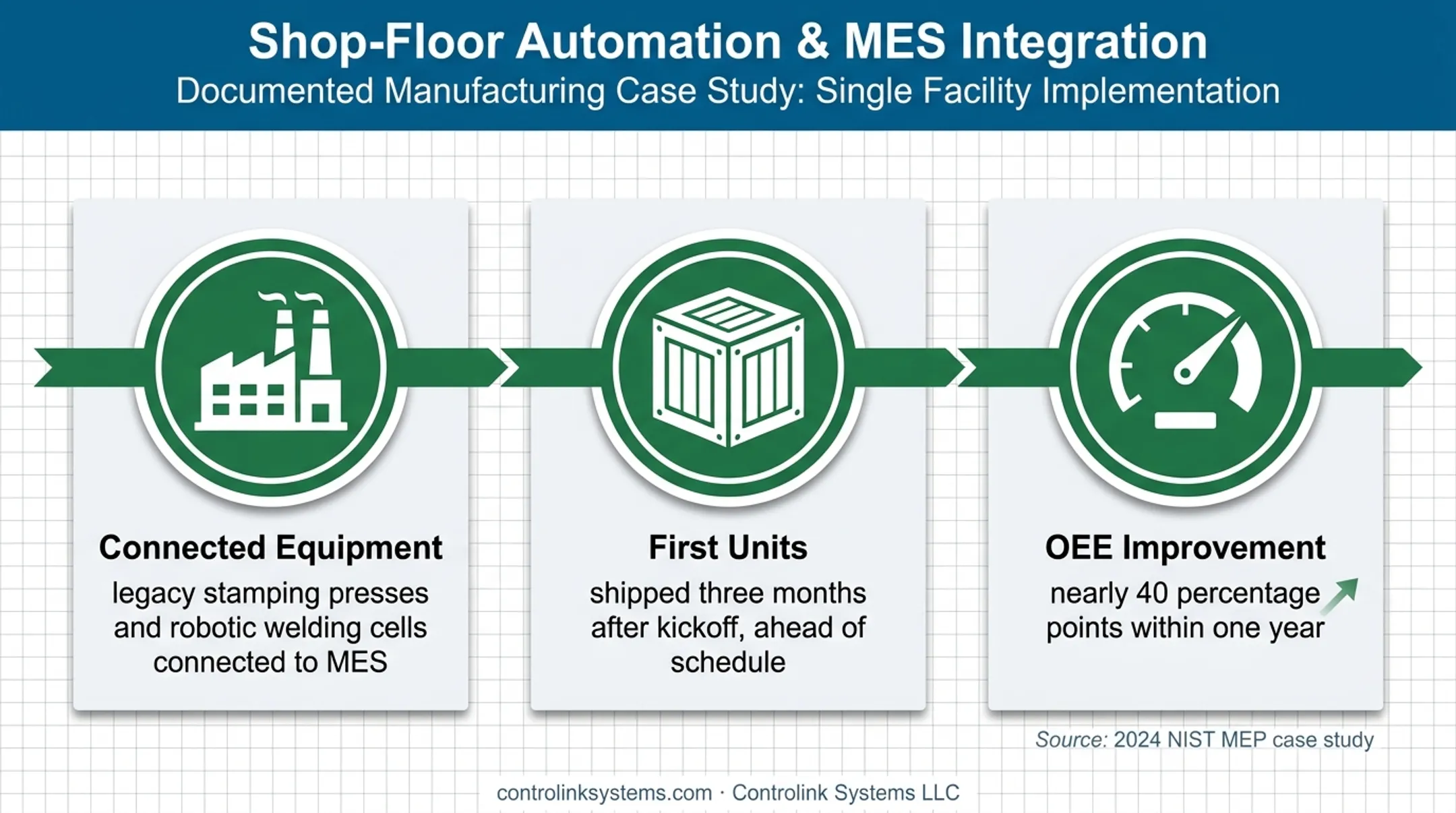

Phased manufacturing technology rollout timeline with shipping and OEE results

Controlink Systems LLC has built CNC/DNC communications, shop-floor automation, and process monitoring software since 1998, routinely linking SQL databases, PLCs, and motion controllers over protocols such as CAN, Modbus, and EtherCAT—the same system-linking work most analytics rollouts need before dashboards mean anything.

Choose software that connects trustworthy data to a repeatable shop-floor action. A platform that produces attractive dashboards but doesn't change a single decision isn't worth the integration effort.

Conclusion

Program-delivery data explains what instructions reached the machine. Machine data explains how the equipment and process actually performed. Together, they give quality, maintenance, engineering, and production teams evidence they can act on, instead of guesswork dressed up as a report.

Start with a specific shop-floor problem, then build from there:

  • Govern your program and machine data
  • Validate results with frontline expertise
  • Expand only after that first use case earns trust

Take an hour this week to audit your current CNC/DNC, machine, and quality data flows. Find one performance question your existing reports can't answer reliably. That's your starting point.

Frequently Asked Questions

What is manufacturing analytics?

Manufacturing analytics combines production, machine, program-delivery, quality, and business-system data to show what happened on the shop floor, why it happened, what is likely next, and what to fix.

What is the best software to track manufacturing processes?

Choose software that fits your machine connectivity, CNC/DNC needs, existing integrations, and the KPIs you must improve. Favor tools that unify program-delivery and machine data over any single “best” product label.

What software is commonly used for data collection?

Shops typically collect data through CNC/DNC systems, MES, SCADA, PLC-connected apps, historians, IIoT platforms, quality systems, ERP, CMMS, and machine-monitoring tools—then feed those sources into analytics.

What are the top 5 data analysis tools?

Manufacturing teams usually rely on five analysis types, not a fixed vendor ranking: descriptive dashboards, diagnostic drill-downs, predictive forecasting, prescriptive optimization, and SPC tools such as control charts and Pareto analysis.

What are the top 5 data management tools?

Data management on the shop floor typically spans industrial historians, MES/MOM collection systems, CNC/DNC program repositories, standards-based interoperability layers, and PLC/CNC interfaces such as OPC UA.

What are the five types of software used in manufacturing?

The common categories are ERP for business planning, MES for production operations, CNC/DNC for shop-floor communications, SCADA/PLC for industrial control, and CMMS/QMS for maintenance and quality. Analytics typically connects data across all five.
